Hunter Central Coast Renewable Energy Zone

Network infrastructure upgrade
Ausgrid is the network operator delivering network infrastructure upgrades required to support the Hunter-Central Coast Renewable Energy Zone (HCC REZ), following the determination by Energy Corporation of NSW (EnergyCo).

The HCC REZ is critical to ensuring the renewables potential of the Hunter area can be harnessed to deliver a reliable and sustainable energy supply for the region. It is the biggest enhancement to the Ausgrid network in more than 25 years. The HCC REZ will have the capacity to transfer an additional 1 gigawatt of renewable energy by 2028.

By using our existing easements (electricity corridors) it will minimise impacts to landowners, community and the environment.

What we're delivering

1GW
network transfer capacity
85km
upgrade of existing subtransmission powerlines
Two
new substations
Two
upgrades to existing substations
18km
new underground optic fibre communications cable

Where are we building the infrastructure?

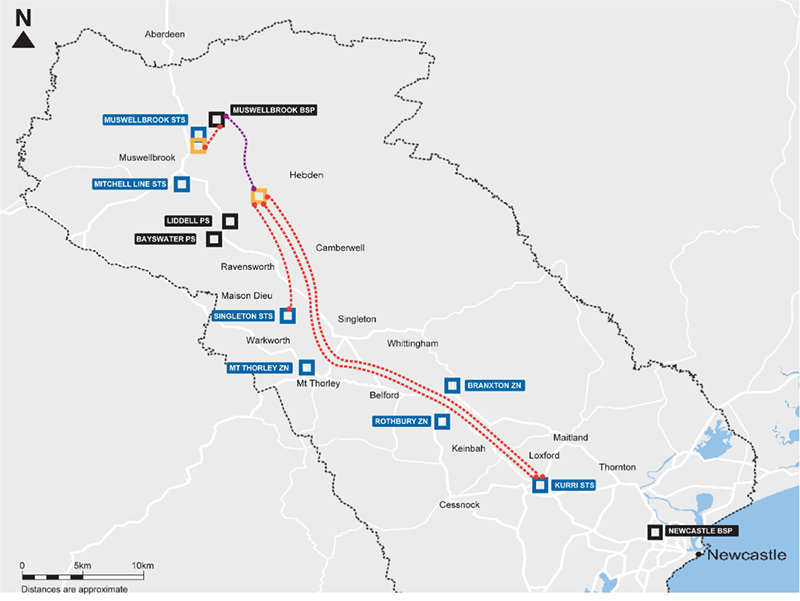

The network infrastructure upgrades run from Kurri Kurri to Muswellbrook.

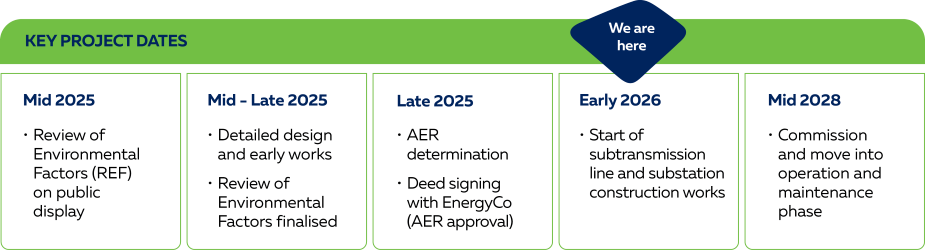

A timeline of the project phases

Regional employment and business opportunities

As this project progresses, it opens new business opportunities and supply chain needs. Businesses can register their capabilities through our ICN Gateway page.

By registering, businesses can showcase their products and services to be a part of the project’s supply chain.

Frequently Asked Questions

  • What is a renewable energy zone?
    Renewable energy zones (REZs) are the modern-day equivalent of traditional power stations. They are regions where new wind and solar power generation (sometimes called ‘farms’) are grouped, so electricity can be efficiently stored and distributed throughout NSW.
  • What is the HCC REZ?

    The HCC REZ is the Renewable Energy Zone, declared by the Minister for Energy in 2022, that stretches through parts of the Central Coast, Newcastle and Hunter regions.

    This region will become host to numerous solar, wind and hydro generation projects, as well as large-scale batteries, delivering an additional 1GW network transfer capacity to the grid.

  • Why has the Hunter-Central Coast area been chosen for a REZ?

    The Hunter and Central Coast regions have excellent renewable energy resources and can utilise existing power stations, rehabilitated mining land, electricity network infrastructure, port and transport facilities, and a skilled workforce, making it an excellent choice for a REZ.

  • What upgrade works will Ausgrid undertake?

    Ausgrid’s proposed works include:

    • Upgrading 85km of existing sub-transmission power lines
    • Building two new energy hubs (substations)
    • Upgrading two existing energy hubs (substations)
    • Installing 18km new underground fibre optic communications cable

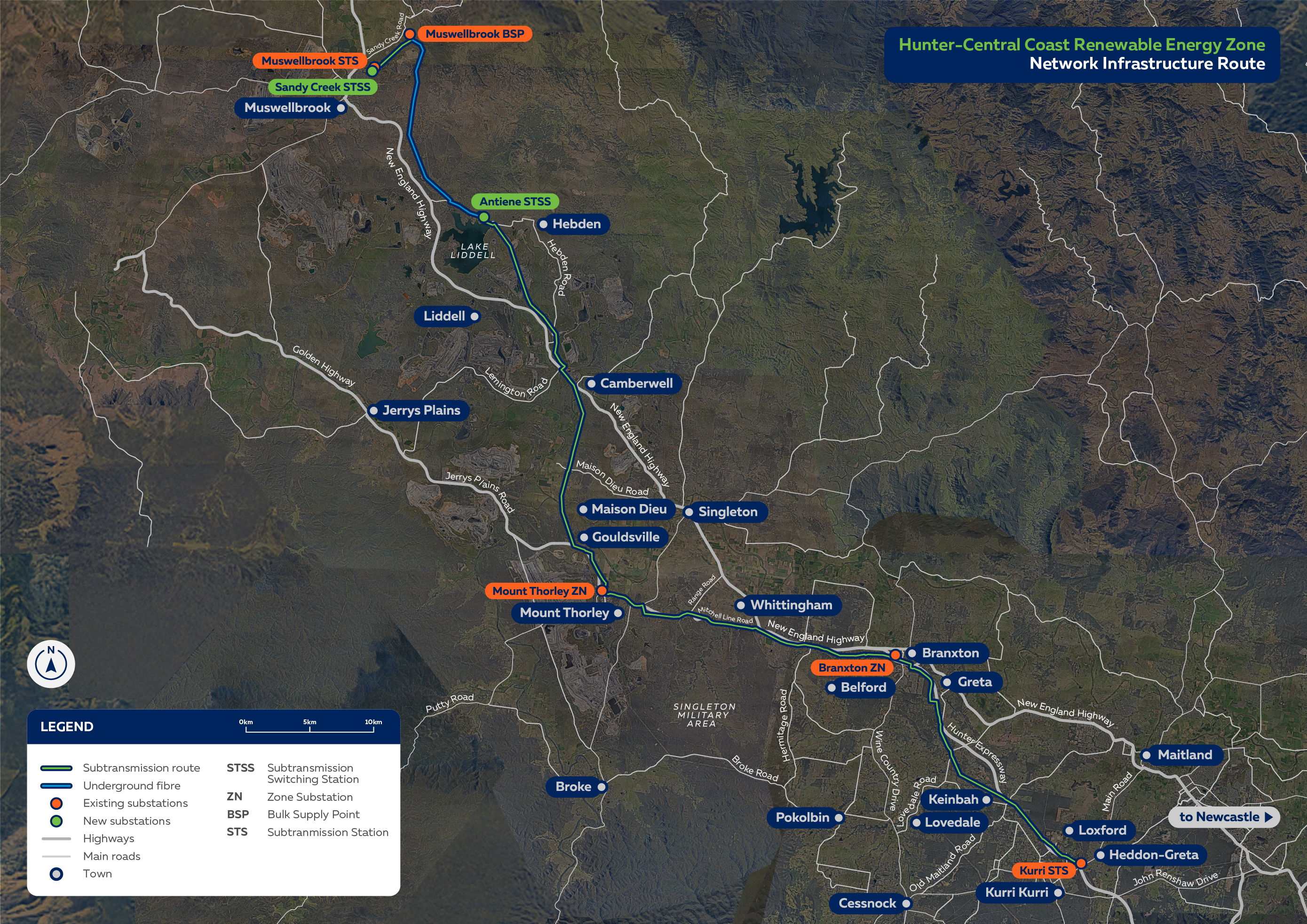

    The proposed network infrastructure upgrades run from Kurri Kurri to Muswellbrook.

  • Why are these upgrades needed?

    To enable the increase in network capacity, upgrades need to be made to the existing infrastructure.

  • What role will Ausgrid play in the HCC REZ?

    In December 2024, Ausgrid signed an agreement with EnergyCo to be the preferred network operator to provide an additional 1GW of renewable energy transfer capacity by 2028. Ausgrid is responsible for the planning, design, construction, financing, operating and maintaining the network infrastructure of the HCC REZ project.

  • What will the new poles and wires infrastructure look like?

    Ausgrid will replace approximately 85km of existing sub-transmission lines between Kurri Kurri and Muswellbrook.

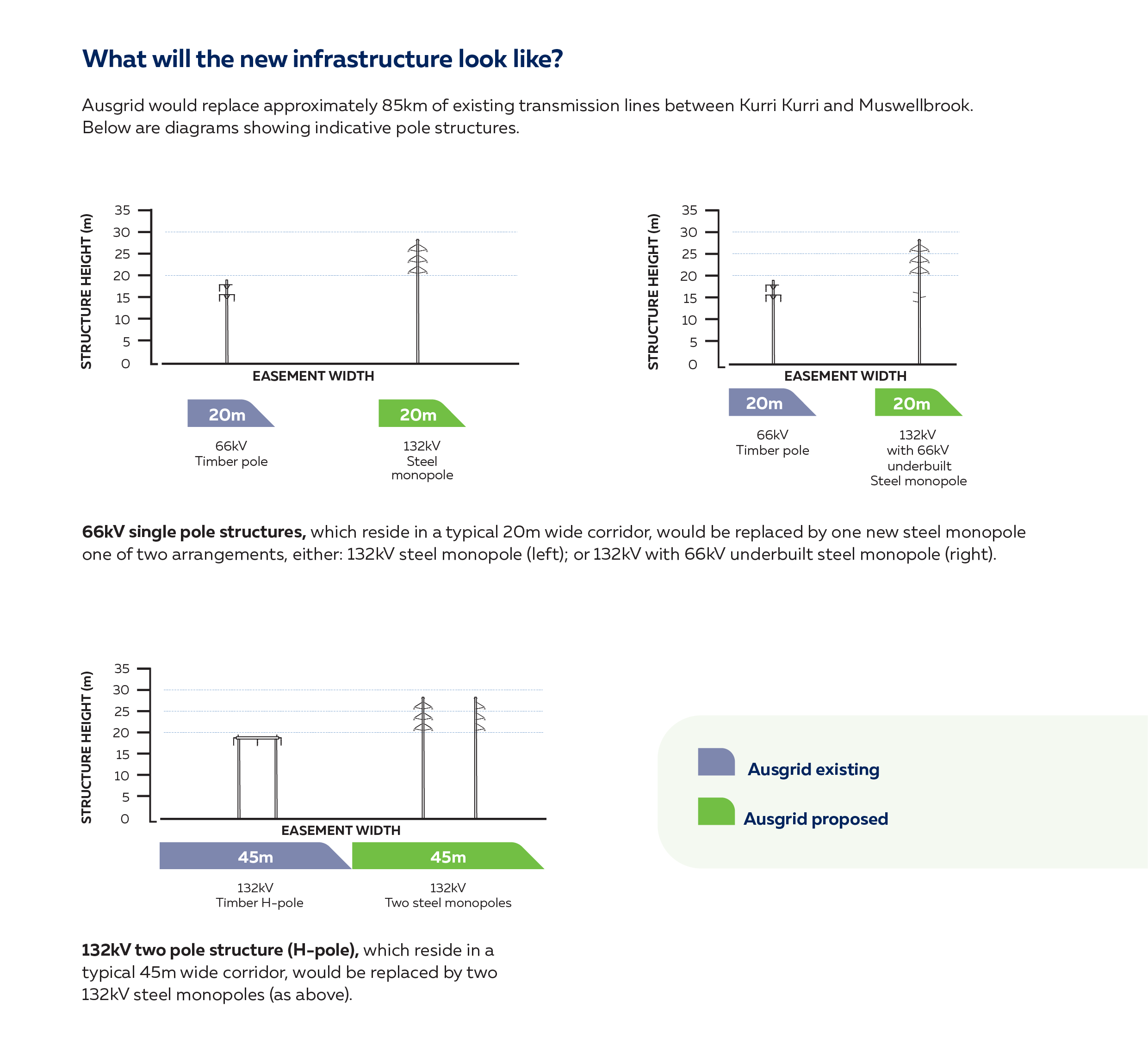

    Timber poles would be replaced with taller, stronger, metal monopoles, like this:

    Ausgrid HCC REZ Infrastructure

    • 66kV single pole structures
    • 132kV two pole structures
  • Where will the new substations be located?

    The proposed new substations are located in Muswellbrook (Sandy Creek substation) and Singleton (Antiene substation).

  • What substations will be upgraded?
    The existing Muswellbrook and Mitchell Line substations will be upgraded as part of the network infrastructure works.
  • Are the HCC REZ upgrade and the Hunter Transmission Project (HTP) the same thing?

    No. The HCC REZ upgrades refer to the sub-transmission infrastructure, while the Hunter Transmission Project (HTP) is a new transmission line (lattice towers) project, to connect the Central West Orana and New England REZs with the existing 500kV transmission network at Eraring.

Final Review of Environmental Factors

Ausgrid has reviewed and considered against the requirements of the Environmental Planning and Assessment Act 1979 (EP&A Act) and has determined the Hunter-Central Coast Renewable Energy Zone Network Infrastructure project approved to proceed to construction.

Review of Environmental Factors

Under the Environmental Planning and Assessment Act 1979, Ausgrid is the determining authority for this project. As part of the REF process, an environmental assessment (known as a Review of Environmental Factors, or REF) has been prepared to assess the potential environmental impacts associated with the project.

Community Engagement

Ausgrid is working closely with the community and regional stakeholders during the delivery of the HCC REZ.

Planning, designing and building new electricity network infrastructure in the Hunter and Central Coast regions requires a detailed understanding of the area’s future large energy users and renewable energy projects.

Ausgrid is dedicated to working continuously with local landowners, communities and businesses, to ensure we deliver social value to the communities that will host the infrastructure required.

  • Will landowners be affected?

    Yes, some landowners will be affected.

    Wherever possible, Ausgrid has used the existing infrastructure corridor to minimise potential impact on landowners.

    We have been in contact with owners of affected land will continue to work with these important stakeholders throughout the lifetime of the Project.

  • How will impacts to landowners be managed?

    EnergyCo and Ausgrid are committed to working with potentially affected landowners to minimise impacts on farming, mining and other business activities through the life of the project.

    During the planning phase, we want to understand farming operations and other possible property impacts or concerns to inform the design and location of the sub-transmission route.

    This could include avoiding dwellings, limiting construction access, and other amenity issues.


  • What traditional lands is the HCC REZ on?
    The HCC REZ will be hosted on the traditional lands of the Wanaruah, Awabakal, Worimi and Darkinjung people, cared for by their Land Councils, as well as the Bahtabah, Biraban, Mindaribba and Karuah Local Aboriginal Land Councils.
  • What consideration is given to the traditional owners?
    During ground investigations as part of preparing the Review of Environmental Factors (REF), Ausgrid (and our sub-contractors) will coordinate with the appropriate Local Aboriginal Land Committee (LALC), to have a cultural liaison representative present.

Find out more about the project at our upcoming community events by chatting to an Ausgrid team member.

Upper Hunter Show – 20 March

Tocal – 2-3 May

Festival of the Fleeces – 6-8 June

Customers and crews talking

Community drop-ins and project notifications

For more information on upcoming drop-in sessions and webinars, and register to receive project updates.

Keep me informed

We are proud to support the Wanaruah / Wonnarua Community Energy Strategy

A strategy for future of energy in the Wanaruah / Wonnarua Community, developed by the Wanaruah Local Aboriginal Land Council (WLALC), Wonnarua Nation Aboriginal Corporation (WNAC), and the Ungooroo Aboriginal Corporation (UAC).

Read more

For more information or to discuss the project further, contact our team:

Phone: 1800 955 635 Mon to Fri, 9am - 4pm

Email: HCCREZ@ausgrid.com.au

Mail: Ausgrid HCC REZ,

GPO Box 4009 Sydney NSW 2001
